Tapioca Starch Plant Upgrade: How Can I Increase Production Capacity?

Date:September 20, 2026/ FAQ/ Chat online/ Technical support

You can lift a tapioca starch plant’s output by 50% or more without rebuilding it or adding a second line. The work almost always lands on three stages: rasping, separation, and drying. Find which one caps your plant, upgrade the equipment and process there, and the rest follows.

The path is the same for almost every plant: locate the bottleneck, scope the upgrade on your existing line, change what each stage needs, then install with minimal downtime and ramp up.

1. Find the bottleneck that caps your capacity

Capacity rarely fails everywhere at once — it fails at one point. Find it before you buy anything.

Four stages usually cap a tapioca starch plant:

Rasping / extraction — sets both yield and throughput; a coarse cut leaves starch in the fiber

Separation / washing — sets purity and separation capacity; grade drops as you push speed up

Drying — the final, often hardest limit; moisture won’t drop and the whole line waits

Water and energy loop — feeds all of the above; utilities hit their limit first

Don’t guess. Run a one-week production log and record two numbers at every stage: output per hour and downtime. The stage with the lowest sustained throughput, or the most stoppages, is your bottleneck. Upgrading any other stage just moves the queue — it does not raise total output.

tapioca starch production facilityTapioca starch processing plant upgrade solution

2. Scope the upgrade on your existing line

You are upgrading the line you already have, so the question is not “upgrade or build new” — it is which stages to touch, in what order, and how deep.

Two scopes fit most plants:

Single-bottleneck fixStaged full retrofit
What it touchesOne stageEach stage, in sequence
DowntimeA weekendSeveral short windows
PaybackFastestLonger, but near new-build
Best whenOne stage clearly caps youSeveral stages near their limit

Do the highest-return, shortest-downtime stage first. Keep what still works — motors, frames, conveyors — and replace only the bottleneck parts. Before you commit, answer two questions: what is your budget, and how many downtime days can you absorb? Those two numbers decide how many stages you move at once.

A supplier such as Jinrui Foodtech (Henan Jinrui) can run an upgrade assessment first and scope the work to your actual bottleneck, so you avoid paying to replace equipment that still has life in it.

3. What to change at each bottleneck stage

Three stages set the plant’s ceiling — rasping, fiber sieving + starch refining, and drying. The remaining stages should keep pace, and only get attention once the big three have been lifted and they become the new constraint.

StageWhat caps youEquipment changeProcess change
RaspingYield + throughput startRasper capacity (t/h), blade material & sharpness, screen aperture, feed uniformityFiner particle size; tight rasping-to-extraction window; circulation load
Fiber sieving + refiningPurity + separationMore sieve/centrifuge stages, curved screens, desander, refining passes2→3 wash stages; water-to-starch ratio; wash-water recovery; purity target
Dewatering + dryingThe real limitDewatering unit + dryer type (flash/cabinet/rotary), cyclone, dust collectionMoisture into dryer; residence time; outlet moisture

3.1 Rasping & extraction

A well-set rasping stage recovers 5–8% more starch from a baseline of 85–88% recovery, and that alone often pays back an upgrade within a year. Coarse rasping leaves starch in the fiber — no later stage gets it back.

3.2 Fiber sieving, desanding, and starch refining

Upgrading from 2–3 to 4–5 screening stages typically lifts separation capacity by 30–60% and cuts specific water use. Skip this and the line runs faster upstream but ships a lower grade — the upgrade created a bottleneck in quality, not just volume.

3.3 Dewatering and drying

The variable that matters most is moisture into the dryer, which the dewatering stage sets: drier feed means the dryer handles more throughput. Rasping and separation can be lifted all day, but if moisture does not drop, the whole plant still waits on the dryer.

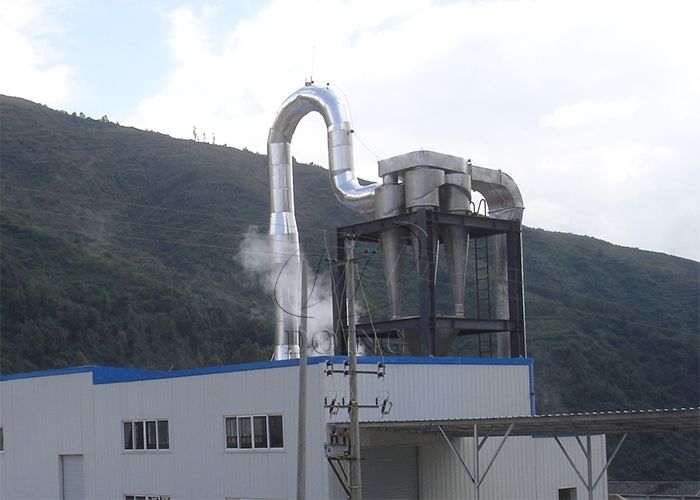

tapioca starch drying machineFlash dryer for tapioca starch production

4. Plan installation, utilities, and ramp-up

An upgrade only pays if the line comes back fast and runs steady.

Schedule off-season where you can, install new modules in parallel so the old line keeps running, and switch over in stages.

Bring utilities up with the process — water loop, steam, PLC controls, instrumentation. A bigger rasper behind an unchanged water or power supply just moves the bottleneck to the utilities.

Ramp up with checks — calibrate new set points, retrain operators on the changed stages, and compare yield and moisture against samples from before the upgrade.

Jinrui Foodtech provides on-site installation supervision, operator retraining, and spare-parts support, and can plan a phased retrofit that keeps the existing line running.

5. Frequently Asked Questions

Q1: How long does the upgrade take, from order to running at the new capacity?

Manufacturing and delivery run 30–75 days, plus 3–6 weeks by ocean freight. Commissioning on an existing line is usually shorter — one to a few weeks. Plan civil or utility tie-ins in parallel so they don’t extend live downtime.

Q2: How do I decide whether to phase the upgrade or shut the line down and do it in one go?

Phase if you must keep shipping — bring new modules beside the running line; do it all at once if you have a seasonal stop, since that’s usually cheaper to install. Rule of thumb: phase when one or two stages move, plan one shutdown when three or more change. Before committing, confirm the old line can run safely beside the new modules and your team can run a half-upgraded line for the weeks it takes.

Q3: What if my production log points to two stages at once, or the bottleneck keeps moving?

When two stages tie, fix the earlier one first. If the bottleneck drifts, check the dryer outlet: moisture or purity drifting there while upstream runs fine means the limit is downstream. Rule out utilities before equipment — a rasper that stalls under load usually signals a power or water shortage. A second, shorter log on just the tied stages settles most ties.

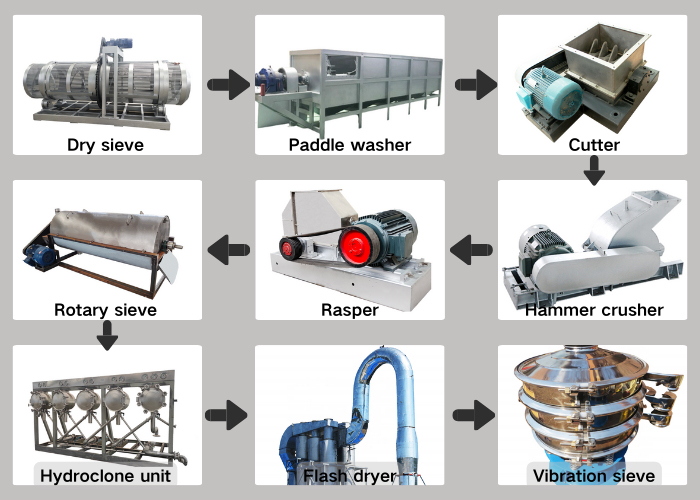

equipment for tapioca starch processingAutomatic tapioca starch processing equipment

Q4: What should I verify with the supplier before signing, so the upgrade actually raises output?

Size every stage to the same target, not just the slow one — a faster rasper behind an unchanged dryer leaves you at the old ceiling. Get the dryer–dewatering match in writing and confirm utilities — water, steam, power — are sized for the upgraded line. Those three checks catch most upgrades that look right but ship no extra starch.

Q5: How much of my existing line can I keep, and is there a ceiling to how much one line can be expanded?

Most owners keep the supporting structure and replace only the bottleneck components, protecting the larger share of the original investment. Before reusing a piece, confirm it meets spec for the new capacity; anything undersized or worn drops first. A single line also hits hard limits — its building, utilities, and slowest fixed stage; past those, a second line costs less. Scope each step against those limits so you know when you are near the wall.

6. Expand your capacity, stage by stage

Capacity grows when you find the bottleneck, scope the upgrade to it, and bring water, power, and automation up with the process. Send Jinrui Foodtech your current capacity, target capacity, and the stage you suspect is capping you, and get an upgrade assessment and a staged implementation plan built around your existing line.
